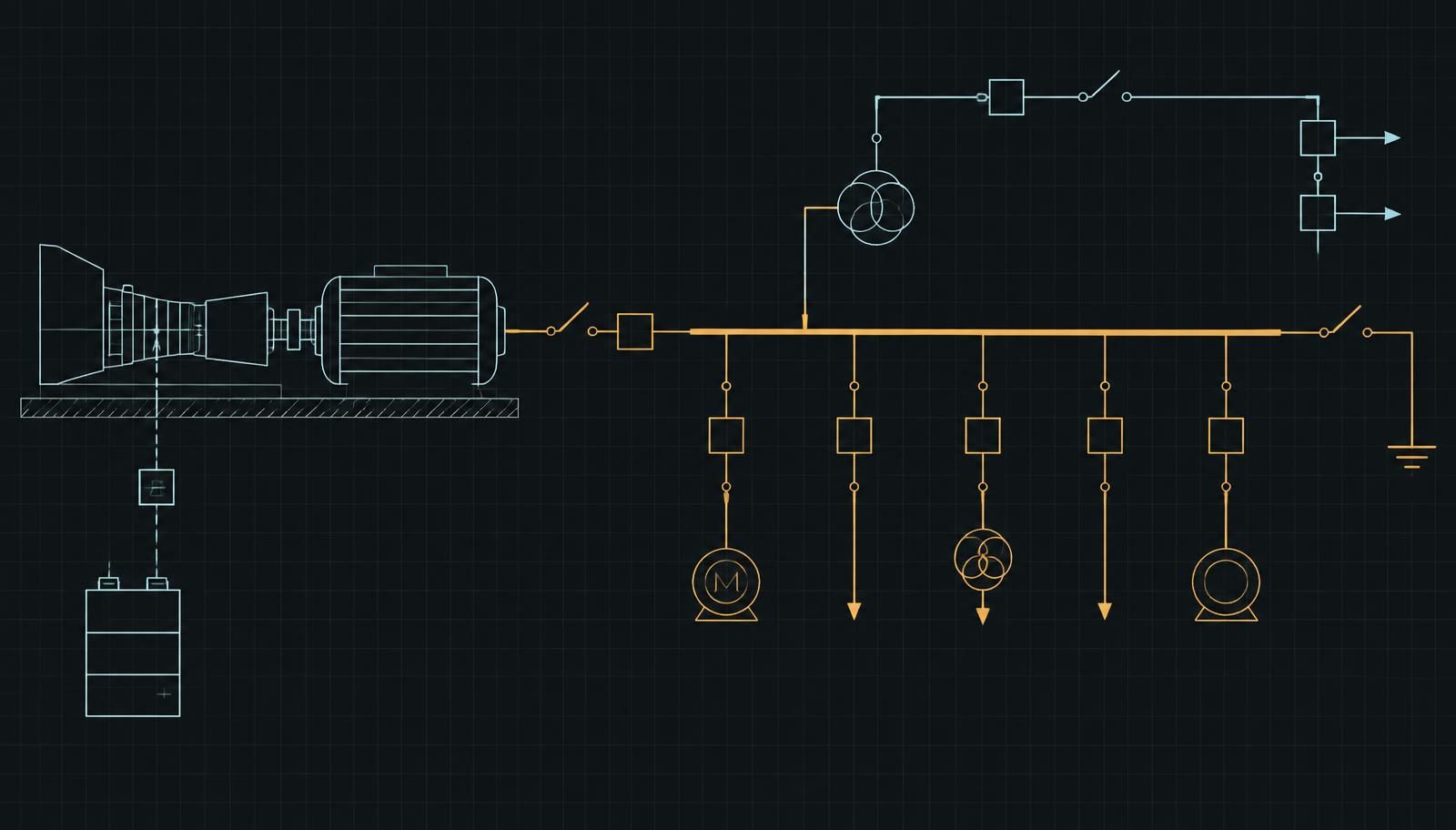

Gas turbine black start requires a complete system that can start the generating plant without external grid power. Verify the starting source, auxiliary loads, fuel availability, controls and load-restoration sequence. A fast-start specification alone does not establish black-start capability, and successful turbine startup does not establish uninterrupted power for the facility.

For a buyer, the useful question is what the offered equipment can restore from a defined starting condition. That might be the turbine's own auxiliary bus, an industrial process, a data-center electrical system or part of a utility network. Each scope requires different equipment and evidence.

Start with the gas turbine equipment hub, then qualify the complete starting arrangement for each shortlisted package. The purchase enquiry should state the blackout scenario, the loads that must return and the time allowed. Otherwise, suppliers can describe different capabilities using the same black-start label.

Key Takeaways

  • Define the initial blackout condition and the final restoration point before comparing equipment.
  • Trace every auxiliary and fuel dependency required before the turbine can supply its own power.
  • Size battery or generator support for power demand, duration and repeat attempts separately.
  • Distinguish fast starting, island operation, load acceptance and uninterrupted facility supply.
  • Require a documented sequence and an agreed demonstration for the actual installed system.

Define what the plant must restore#

Black start means starting without support from the external electrical grid. Island operation means supplying an electrically separated system. A plant may be capable of continuing in an island after separation yet still need external power to restart from a stopped condition. Keep those operating cases distinct in the enquiry.

Also distinguish restoration from continuity. If sensitive equipment must remain energized during an outage, another part of the electrical architecture must carry it through the interruption and restart sequence. A turbine that eventually restores supply cannot, by that fact alone, provide uninterrupted service.

Restoration scope to define before requesting a quotation#

Question Required project definition
Initial state Turbine stopped; shutdown and blackout duration; available stored energy and fuel
Electrical boundary Buses and connections isolated from the external grid
First supported loads Controls, lubrication, ventilation, fuel systems and starting equipment as applicable
Restoration target Turbine auxiliaries, selected facility loads, the full site or an agreed network section
Timing Allowable interruption and deadline for each restoration stage
Repeatability Required attempts and recovery assumptions after an unsuccessful start
Operating environment Ambient conditions, fuel conditions and equipment unavailable in the scenario

For a data center, involve the team responsible for UPS systems, switchgear, cooling and load restoration. IT demand is only part of the site requirement. The backup-power procurement discussion provides related context; the black-start enquiry must describe the actual systems that keep the facility operating or bring it back.

Treat these definitions as common bid inputs. A supplier proposing restoration of a lightly loaded auxiliary bus has answered a different question from one proposing a fully demonstrated facility restart. Compare them only after their scope and timing boundaries match.

Specify running-to-island transfer as a separate operating case. For the black-start case, document the services that remain available while the turbine is stopped, including any independent starting generator or battery. A test that quietly retains normal grid-fed auxiliaries leaves that starting condition unproven.

Read fast-start specifications on their own terms#

A published start time describes a capability within stated equipment and operating conditions. It does not automatically include restoration of a dead auxiliary system, fuel preparation, a failed attempt, load pickup or the facility's return to service. Ask where the timing begins and ends.

GE's September 2025 LM2500XPRESS factsheet provides a specific example. The selected reference below is an OEM fast-start figure for a named simple-cycle variant. The datasheet does not provide a complete black-start design for a purchased used package. GEA35746 LM2500XPRESS factsheet.

Published fast-start reference and its scope#

Field OEM reference or limitation
Selected configuration LM2500XPRESS+G4 DLE UPT; simple cycle
Listed frequency offering 50/60 Hz
Fast-start capability 5 minutes
Published reference conditions ISO conditions; natural gas
Performance qualification Indicative information; actual performance depends on project conditions
Black-start conclusion Starting-source size, dead-bus sequence and facility restoration are not established by this row

Keep the start-time evidence with the offer, but request the separate sequence that applies when the grid is unavailable. The LM2500 dossier identifies the equipment family. It does not demonstrate the starting systems installed on a particular offered unit.

Ask whether the quoted arrangement assumes warm equipment, available cooling, control power, pressurized fuel or an already energized bus. Record the answer without silently substituting a more favorable starting state. The site's required restoration time must cover the full relevant sequence, including the services needed before the turbine start command.

Trace the auxiliary and fuel dependencies#

Work backward from successful turbine operation. Identify the systems that must already function for the starting sequence to proceed, then identify what powers each one. Continue until every essential dependency reaches a source available in the defined blackout scenario.

The resulting list is configuration-specific. It can include controls, lubrication, ventilation, fuel treatment, gas compression, cooling, instrument air and starting equipment. Some functions may be driven mechanically or supported by dedicated systems. Obtain the actual load list and sequence, identifying which demands the proposed starting source must supply.

Dependency questions for the supplier and site engineer#

System Question that must have an answer
Controls and protection What powers controllers, relays, communications and breaker operations initially?
Lubrication and cooling Which functions are required before, during and after a start attempt?
Ventilation and purge What services and timing are required by the approved sequence?
Fuel delivery Is suitable fuel available without grid-dependent site equipment?
Starting system What electrical or other starting source is installed, and what does it require?
Auxiliary transfer How do auxiliaries transfer to normal supply after generation is established?
Unsuccessful start What remains powered for protection, recovery and a later attempt?

Fuel availability deserves a separate response. Carnegie Mellon's gas-electric interdependency research summary explains how electrically powered pipeline compression can create outage exposure. This does not establish the reliability of a particular supply route. Ask the fuel provider and site team about the dependencies relevant to the proposed plant.

GE's Colorado Springs LM2500XPRESS case study describes gas compressors in the power blocks and a separate black-start diesel generator in the supplied scope. It is an OEM-reported project example of supporting equipment that belongs in the system boundary, not a standard bill of materials for every LM2500 package.

If liquid fuel is proposed as an alternative, confirm the installed dual-fuel configuration and the ability to supply and start on that fuel in the required scenario. A storage tank cannot by itself establish fuel-system compatibility, transfer capability or independence of the supporting equipment.

Use the gas turbine fuel-requirements enquiry to document the quality, delivery conditions and service assumptions behind the starting sequence.

Compare starting sources as complete systems#

A diesel starting generator and a battery system can each support a black-start design when correctly specified and integrated. Compare them against the same auxiliary sequence, operating conditions and required attempts. Their power delivery, stored energy, maintenance and recovery arrangements differ.

GE reports a battery-assisted start of a heavy-duty turbine in its Entergy Perryville case study. This demonstrates a reported project application, not the capability of every GE 7F unit offered for sale. Request the actual starting hardware and commissioning evidence for the candidate equipment.

For battery support, establish whether the inverter can energize the required bus without an external voltage reference. The U.S. Department of Energy's inverter explanation distinguishes grid-forming operation from grid-following operation. Confirm the proposed controls, protection and energization sequence at the system level; the presence of batteries alone leaves those questions unanswered.

Starting-source comparison for a common restoration duty#

Assessment Generator-supported start Battery-supported start
Initial readiness Starting batteries, fuel and required auxiliary systems Usable state of charge, inverter and required auxiliary systems
Power delivery Applicable generator and motor-starting performance Inverter power, current and overload capability
Duration Usable fuel and operating conditions Usable energy over the required sequence
Repeat attempts Fuel, recovery time and equipment limitations Remaining energy, recovery time and equipment limitations
Later readiness Refueling and service arrangements Recharge source, recharge time and service arrangements

Where a battery also provides other services, preserve the energy needed for the agreed restoration duty. Siemens Energy describes both black-start support and ancillary-service participation at Leipzig Süd on its BESS product page. That OEM example raises a practical specification question: what controls prevent routine operation from consuming the required start reserve?

Calculate power and energy separately#

Battery power is the rate at which energy can be delivered; usable energy determines how long that delivery can continue. Both matter during a start. A system may have enough stored energy but insufficient inverter capability for a motor-starting event, or sufficient power but too little energy for an extended sequence.

Build a chronological auxiliary-load schedule. Identify loads that overlap and those that stop before the next stage. Include the supporting system's own consumption and conversion losses at a clearly defined boundary. The responsible electrical engineer should assess active power, reactive power, current and transient behavior together.

The following example is editorial arithmetic using invented loads. It is not an OEM requirement, a battery quotation or a design for any named turbine. The rows describe sequential stages with constant aggregate active power at an assumed AC delivery boundary.

Illustrative energy calculation for one start sequence#

Sequential stage Assumed aggregate AC load Assumed duration Delivered energy
Preparation 0.5 MW 10 minutes 0.0833 MWh
Starting interval 2.0 MW 5 minutes 0.1667 MWh
Stabilization and transfer 0.8 MW 15 minutes 0.2000 MWh
Total Maximum listed stage: 2.0 MW 30 minutes 0.4500 MWh

For each stage, energy MWh = power MW × minutes ÷ 60. The unrounded sum is (0.5 × 10 + 2.0 × 5 + 0.8 × 15) ÷ 60 = 0.45 MWh. The maximum listed active-power stage and the energy total answer different questions.

0.45 MWh — The illustrative sequence delivers this much AC energy, before adding losses, reserve, recovery duties or additional attempts.

The example is deliberately incomplete as a battery specification. It excludes starting transients, reactive demand, system losses, temperature effects, aging allowances and protected reserve. Do not select inverter power or battery nameplate capacity directly from the table. Obtain a supplier calculation that converts the agreed duty into usable system capability at the required conditions.

An unsuccessful attempt may consume energy differently from a completed start and may require additional cooling, purge or recovery duties. Siemens Energy's BASF modernization account describes a requirement for consecutive starts without recharging. Treat that as a project-specific requirement, then define the attempts and recovery sequence appropriate to this purchase.

Demonstrate load acceptance after startup#

Once the turbine is operating, the plant must accept the intended loads while maintaining acceptable electrical conditions. Ask for the proposed load-restoration sequence and the engineering evidence supporting it. A steady-state output rating cannot establish the response to a sudden motor start or a large load transfer.

Define the largest credible load additions and removals, their timing and the operating equipment at each stage. Include transformer energization, motor acceleration and power-electronic loads where relevant. Model the proposed generator, excitation, governor, protection and load controls using the actual configuration and supplier-supported settings.

For a plant built around an SGT-800 candidate, request the same system evidence as for any other turbine. The model choice does not remove the need to demonstrate stable operation with the intended site loads and the actual supporting equipment.

Agree how evidence progresses from design studies and control testing to site demonstration. Define acceptable frequency and voltage behavior, unsuccessful-test handling and conditions that require retesting. Keep the project limits with the responsible electrical team; a procurement article cannot supply universal transient limits for every facility.

Evidence to retain from an agreed black-start demonstration#

Test boundary Evidence the acceptance record should contain
Initial condition Stopped-turbine state, independent sources and any temporary services used
Starting sequence Auxiliary power and fuel availability through startup and transfer
Load restoration Time-stamped load steps and the corresponding voltage/frequency records
Readiness afterward Remaining fuel or usable battery energy, recovery duties and recharge plan

Have the commissioning team record departures from the agreed initial condition. If temporary equipment helped complete the demonstration, identify whether it belongs in the permanent scope or whether another test is needed. Completion of the turbine start sequence should remain distinguishable from acceptance of the facility restoration duty.

Include the transition back to normal supply in the operating scope. Establish how the island reconnects, how load is transferred and which systems must recover before the next event. The power procurement and interconnection roadmap provides broader coordination context. Restoration is complete only at the boundary agreed for the project.

Check the generating package's frequency and electrical compatibility alongside the controls and protection proposed for island operation.

Put black-start evidence into the purchase enquiry#

Give the supplier the initial state, restoration target, required timing and demand sequence. Request the equipment list, auxiliary schedule, fuel dependencies, control narrative, single-line diagram and test evidence for the offered arrangement. Require explicit exceptions where the existing package cannot meet the proposed duty.

For used equipment, verify whether starting generators, batteries, chargers, inverters and auxiliary switchgear are included and serviceable. Confirm access to control software, settings and technical support. If the black-start capability depends on replacement components, show who supplies and commissions them and when the complete system becomes available.

Compare alternatives on the same service requirement. Gas engines, diesel equipment, solid-oxide fuel cells and solar with storage may fill different roles in a facility architecture, subject to their demonstrated capabilities. The fuel-cell and turbine comparison supports that wider equipment assessment without establishing any candidate's black-start performance.

SecondWatt provides independent equipment intelligence and connects buyers and sellers without taking equipment into inventory. Send the proposed restoration duty, site constraints and candidate equipment details to info@secondwatt.com to discuss a qualified enquiry. The useful output is a complete, testable starting scope with identifiable dependencies.

FAQ: gas turbine black start#

Is black start the same as a fast start?#

No. Fast-start capability concerns a timed starting sequence under stated conditions. Black-start capability concerns starting without external grid support. A purchase specification should define both where needed, including the initial state, available auxiliaries and the point at which the required load is restored.

Can a gas turbine use batteries for black start?#

Battery-supported systems have been applied to gas-turbine plants. Suitability depends on the actual auxiliary duty, inverter capability, usable energy, controls and protection. Confirm the proposed system through supplier engineering and agreed testing. An OEM case study establishes a reported application, not a sizing rule for another plant.

Does a battery's MW rating show how many starts it can support?#

No. Power capability and usable energy must be evaluated separately. Repeated attempts also depend on their duration, recovery duties, system losses, starting state of charge and equipment limitations. Obtain a sequence-based calculation that explicitly includes the energy remaining after each attempted start and its recovery duties.

Does black-start capability guarantee uninterrupted data-center power?#

No. Restoring generation and maintaining uninterrupted supply are different duties. The facility architecture must support loads through any interruption and restoration interval. Verify the roles of UPS systems, storage, backup generation and load controls alongside the turbine's starting and load-acceptance performance.

What if the gas compressor needs electricity?#

Include its actual starting and operating requirements in the dependency assessment. Determine whether the blackout scenario leaves an independent source available and whether upstream fuel delivery remains feasible. If another fuel is proposed, verify the installed equipment and the complete starting sequence on that fuel.

What evidence should accompany a used black-start package?#

Request equipment identities, configuration records, auxiliary-load data, starting-source condition, control documentation and available test results. Identify missing components and changes needed at the receiving site. Agree how the installed system will demonstrate the required restoration duty and how remaining deficiencies will be resolved before acceptance.
