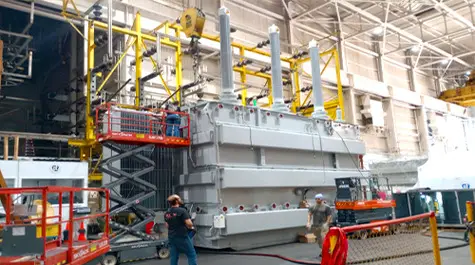

Pennsylvania Transformer Technology Power and substation transformers (5-750 MVA, to 765 kV)

Pennsylvania Transformer power units from 5 to 750 MVA through 765 kV, with a Canonsburg test lab to match
Pennsylvania Transformer Technology Power and substation transformers (5-750 MVA, to 765 kV) is one of 32 data center transformers tracked in the SecondWatt catalogue, each with specifications, lead times and indicative secondary-market pricing.
Pennsylvania Transformer power unit dossier: 5-750 MVA through 765 kV with in-house EHV testing, Quanta ownership, market channels, inspection points.
PTT's power transformer scope is the widest of any US independent in this batch: oil-filled units from 500 kVA to 750 MVA at voltage classes of 69, 138, 345, and up to 765 kV, backed by a 765 kV test laboratory at the Canonsburg campus. The project portfolio spans 5-750 MVA, and specialty lines include unit substation, transit, furnace, zig-zag, and series-multiple designs plus EHV shunt reactors to 150 MVAr at 345 kV. Mobile transformers extend to 50 MVA and 230 kV. Quanta Services ownership ties this capacity to the largest US utility constructor, and the Raeford, North Carolina plant covers small and distribution units at up to 161 kV test capability. Buyers should assume brokered channels and quote cycles, with class lead times of 65-110 weeks at 5-50 MVA and up to 4 years at high capacity.
Why it matters
Only a handful of US plants can build and test above 345 kV, and PTT's 765 kV lab puts it in that group alongside Hyosung's Memphis plant and Hyundai's 2027 Montgomery expansion. With imports at 80% of US power transformer supply and 50% Section 232 tariffs on derivative content, domestically tested EHV capacity carries strategic premium.
Who buys it
Utilities and transmission owners buy PTT power units through 765 kV; industrials take furnace and specialty designs; and Quanta's own project pipeline consumes capacity internally. Data center campuses meet PTT at 69-345 kV interconnect substations, where a domestic builder with in-house EHV testing shortens acceptance cycles.
Role in the data center
Interconnect substation transformer at 69-345 kV for large campuses, domestically built and tested; the alternative to import queues on the critical-path item.
Key specifications
| Power transformer range | 5-750 MVA |
|---|---|
| Voltage classes | 69 / 138 / 345 / to 765 kV |
| Full plant range | 500 kVA-750 MVA |
| EHV test lab | 765 kV (Canonsburg) |
| Shunt reactors | to 150 MVAr / 345 kV |
| Mobile transformers | to 50 MVA / 230 kV |
| Reference unit | 40 MVA / 69 kV project page |
| Class lead time (high capacity) | up to 4 years |
Technical summary
Power transformers: 5-750 MVA Voltage classes: 69 / 138 / 345 / up to 765 kV Full plant range: 500 kVA-750 MVA Test capability: 765 kV (Canonsburg), 161 kV (Raeford) Specialty: unit substation, transit, furnace, zig-zag, series-multiple Shunt reactors: to 150 MVAr / 345 kV Mobile transformers: to 50 MVA / 230 kV Raeford NC plant: small units, 161 kV test capability Ownership: Quanta Services; founded 1929
Pricing and availability
Trend: up Lead time, new: 65-110 weeks (5-50 MVA class); up to 4 years high-capacity. Lead time, used or refurbished: 2-12 weeks. Warranty, used: 3-year typical from major US rebuilders.
Lifecycle and maintenance
Liquid-filled transformers routinely serve 30-40 years with annual oil screening, DGA on a 1-2 year cadence (or continuous online monitoring on critical units), and gasket or bushing service as tests dictate. Major US rebuilders remanufacture units to like-new condition with warranties up to 3 years (T&R Electric, Sunbelt Solomon), and reconditioned stock ships in days against 65-210 week new-build queues. Remaining paper life, estimated by furan testing, governs end-of-life valuation.
Common failure points
- Windings — Dielectric failure; windings dominate major-failure statistics in CIGRE TB 642
- Bushings — Failure share rises with voltage class; OIP bushing faults can rupture tanks
- OLTC — Contact and mechanism wear; prominent failure source on substation units
- Winding deformation — Through-fault or transport damage shifting SFRA signature
- Cooling system — Pump, fan, and radiator degradation derating the unit
- Moisture and paper aging — Furans in oil and reduced degree of polymerization
Inspection checklist
DGA — dissolved gas analysis per IEEE C57.104; combustible-gas trend rise between 2 samples triggers investigation Oil quality — dielectric breakdown, moisture, acidity, and furan tests; degree of polymerization below 200 marks end of paper life Insulation resistance — megger HV/LV/ground; polarization index of 2.0 or higher passes Power factor — insulation power factor testing; values above 1.0% on oil-filled windings warrant investigation Turns ratio — TTR on all taps; deviation beyond 0.5% from nameplate fails Winding resistance — three-phase balance within 2% between phases Bushings — capacitance and power factor test; bushing failure share rises with voltage class per CIGRE TB 642 OLTC — inspect on-load tap changer diverter and selector; OLTCs are a leading failure component in CIGRE TB 642 fleet surveys SFRA — sweep frequency response analysis per IEEE C57.149 against baseline to detect winding deformation after transport Transport records — review impact-recorder data per IEEE C57.150 for any relocated unit of 10 MVA and above Core ground — verify a single intentional core ground; inadvertent grounds show as gassing in DGA Cooling — inspect radiators, pumps, and fans; verify stage ratings (ONAN/ONAF) against nameplate Tank and conservator — corrosion survey, gasket inspection, and pressure relief device function Nameplate verification — confirm MVA stages, impedance, BIL, and 55/65 C rise data against the factory test report Records — complete factory test report, DGA history, through-fault history, and loading records from service
Procurement channels
Direct and Quanta-affiliated for new; brokered dealer channels (Belyea, CTG, Transformer Exchange) for the used class, universally price-on-request at power scale.
