Who buys it
Data centers, hospitals, and industrial plants standardized on Cummins gensets buy DMC controls with their paralleling switchgear through Cummins distributors. Used-plant buyers inherit them and need program files, settings, and distributor support confirmed before commissioning.
Role in the data center

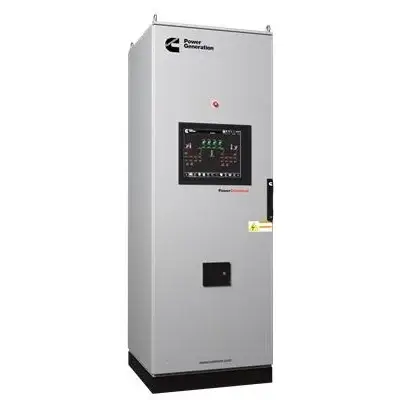

Master paralleling control for Cummins standby plants, sequencing generator start, sync, and load pickup behind the critical bus.
Key specifications
| Product class | Digital master control for generator paralleling (DMC2000 / DMC6000 / DMC8000) |
|---|---|
| Standards | IEC 61439-2, UL 891 |
| DMC2000 scope | Simple power systems; 7-inch touch-screen interface |
| DMC6000 scope | Up to 16 gensets, 16 loads and 2 utilities; 15-inch touch-screen interface |
| DMC8000 scope | Built-to-order; unlimited gensets, utilities and loads |
| Validation | More than 1,200 factory-tested failure scenarios |
| Rating note | A control, not a switching lineup - voltage, current and fault duty belong to the switchgear it drives |
Pricing and availability
Trend: up Lead time, new: 45-90 weeks (engineered switchgear class). Lead time, used or refurbished: Distributor channel; no open used market. Warranty, used: 1-year typical from reconditioning dealers.
Lifecycle and maintenance
Paralleling switchgear iron lasts 30+ years but its control systems turn over every 15-20: PLCs, HMIs, and network hardware go obsolete long before bus and breakers wear out. OEM modernization programs (Kohler switchgear service, ASCO, Eaton, Russelectric) replace controls in place with sequence re-verification and load testing, typically warranted 1-2 years. A used lineup's value concentrates in its breakers and bus; controls should be assumed a retrofit cost unless current.
Common failure points
- PLC and HMI obsolescence — Discontinued controllers and dead touchscreens risk weeks of downtime
- Program and settings loss — No PLC backup means no recovery after controller failure
- Control power systems — Failed batteries and chargers disable the entire paralleling function
- Breaker mechanisms — Sticky electrically-operated breakers miss the paralleling window
- Synchronizer drift — Out-of-window closures stress generators and trip protection
- Sensing and CT wiring — Bad CT/PT inputs corrupt load share and metering
Inspection checklist
Controls vintage — identify PLC generation and firmware; controllers older than 15 years risk obsolescence downtime PLC redundancy — verify dual-master architecture; fail one controller and confirm bumpless transfer HMI — verify touchscreen, alarm history, and event logs; displays are common 10-15 year failures Synchronizer — test sync-check phase, voltage, and frequency windows against settings Breakers — exercise every generator and tie breaker; 5-cycle class closing required for paralleling duty Load add/shed — test priority sequencing through all programmed stages (typically 8) Protection — injection-test generator and feeder relays; verify device 32 reverse-power and 25 sync elements Transfer modes — test open transition and any closed-transition mode; verify the 100 ms utility-parallel limit Bus and cabling — insulation resistance at 1,000 V; torque main bus joints to specification Instrumentation — verify CT/PT inputs read correctly at the HMI against measured values Control power — verify 24-125 VDC systems, charger function, and battery age under 5 years Generator interface — verify start signals, speed and voltage bias wiring, and genset controller comms Standards — confirm UL 1558 or UL 891 construction and NFPA 110 monitoring functions Documentation — as-built drawings, PLC program backups, and settings files; missing programs cripple service Load test — full-system load bank test; verify start-to-loaded-bus timing (NFPA 110 10-second class where required)
