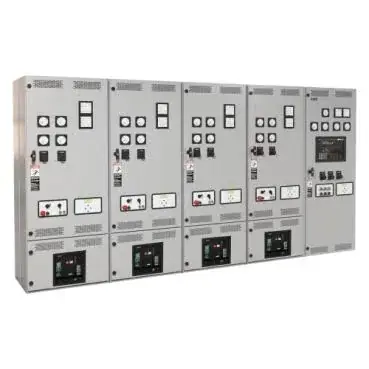

ASCO Power Technologies (Schneider Electric) 7000 Series Low-Voltage Power Control System

ASCO 7000 Series Power Control System, the custom-engineered top tier that shares its name with an ATS family
ASCO Power Technologies (Schneider Electric) 7000 Series Low-Voltage Power Control System is one of 41 data center switchgear tracked in the SecondWatt catalogue, each with specifications, lead times and indicative secondary-market pricing.
ASCO 7000 Series Power Control System dossier: custom generator paralleling lineups, the ATS naming trap, controls lifecycle, and inspection checklist.
Why it matters
Power control systems are the brains of every large standby plant, and their 15-20 year controls lifecycle against 30-plus year iron is the defining economic fact of the category. Publishing the ATS-versus-PCS distinction, with the 399.99 USD versus engineered-lineup contrast, prevents the single most expensive mis-purchase in paralleling gear.
Role in the data center
Generator plant control for large standby fleets: paralleling, sequencing, and utility-interface logic behind the critical bus in hyperscale and hospital plants.
Key specifications
| Product class | LV power control system (custom) |
|---|---|
| Range position | top tier (above 4000 Series) |
| Owner | Schneider Electric (ASCO) |
| Naming trap | 7000 Series ATS is a separate family |
| ATS comp (not PCS) | 399.99 USD (30 A used ATS) |
| ATS channel depth | dedicated eBay category |
| PCS used listings | none found |
| Class lead time | 45-90 weeks |
Pricing and availability
Trend: up Lead time, new: 45-90 weeks (engineered switchgear class). Lead time, used or refurbished: No PCS lineup channel; ATS components 1-4 weeks. Warranty, used: 1-year typical from reconditioning dealers.
Lifecycle and maintenance
Paralleling switchgear iron lasts 30+ years but its control systems turn over every 15-20: PLCs, HMIs, and network hardware go obsolete long before bus and breakers wear out. OEM modernization programs (Kohler switchgear service, ASCO, Eaton, Russelectric) replace controls in place with sequence re-verification and load testing, typically warranted 1-2 years. A used lineup's value concentrates in its breakers and bus; controls should be assumed a retrofit cost unless current.
Common failure points
- PLC and HMI obsolescence — Discontinued controllers and dead touchscreens risk weeks of downtime
- Program and settings loss — No PLC backup means no recovery after controller failure
- Control power systems — Failed batteries and chargers disable the entire paralleling function
- Breaker mechanisms — Sticky electrically-operated breakers miss the paralleling window
- Synchronizer drift — Out-of-window closures stress generators and trip protection
- Sensing and CT wiring — Bad CT/PT inputs corrupt load share and metering
Inspection checklist
Controls vintage — identify PLC generation and firmware; controllers older than 15 years risk obsolescence downtime PLC redundancy — verify dual-master architecture; fail one controller and confirm bumpless transfer HMI — verify touchscreen, alarm history, and event logs; displays are common 10-15 year failures Synchronizer — test sync-check phase, voltage, and frequency windows against settings Breakers — exercise every generator and tie breaker; 5-cycle class closing required for paralleling duty Load add/shed — test priority sequencing through all programmed stages (typically 8) Protection — injection-test generator and feeder relays; verify device 32 reverse-power and 25 sync elements Transfer modes — test open transition and any closed-transition mode; verify the 100 ms utility-parallel limit Bus and cabling — insulation resistance at 1,000 V; torque main bus joints to specification Instrumentation — verify CT/PT inputs read correctly at the HMI against measured values Control power — verify 24-125 VDC systems, charger function, and battery age under 5 years Generator interface — verify start signals, speed and voltage bias wiring, and genset controller comms Standards — confirm UL 1558 or UL 891 construction and NFPA 110 monitoring functions Documentation — as-built drawings, PLC program backups, and settings files; missing programs cripple service Load test — full-system load bank test; verify start-to-loaded-bus timing (NFPA 110 10-second class where required)
Procurement channels
Schneider/ASCO channels for new PCS and modernization; the used channel carries 7000 Series ATS units (from 399.99 USD observed) and components, not power control systems.
